Work plan

Deadlines

  • 2018-02-26 Choose a project proposal and send your choice via email to epsatisep@gmail.com
  • 2018-03-05 Define the Tasks (what must be done - every member should preferably participate in every task), subtask allocation (who does what) and Gantt chart (when) of the project and insert them on the wiki (planning)
  • 2018-03-12 Upload the “black box” System Diagrams & Structural Drafts to the wiki
  • 2018-03-23 Upload the detailed System Schematics & Structural Drawings to the wiki and do the cardboard scale model of the structure
  • 2018-04-04 Upload the List of Materials (what & quantity) to the wiki
  • 2018-04-14 Upload the Interim Report and Presentation to the wiki. The report must contain the Introduction, including the tasks, team members allocation and Gantt chart, State of the Art, Marketing Plan, Project Management, Eco-eficiency Measures for Sustainability, Ethical and Deontological Concerns, Proposed Solution and Bibliography chapters
  • 2018-04-19 Interim Presentation, Discussion and Peer, Teacher and Supervisor Feedbacks
  • 2018-04-23 Complete the List of Materials (local providers & price, including VAT and transportation) to the wiki
  • 2018-05-02 Upload refined Interim Report (based on Teacher & Supervisor Feedbacks)
  • 2018-06-04 Upload the results of the Functional Tests to the wiki
  • 2018-06-15 Upload the Final Report
  • 2018-06-18 Upload the Presentation, Video, Paper, Poster and Manual
  • 2018-06-21 Final Presentation, Individual Discussion and Assessment
  • 2018-06-28:
    1. Update the wiki with all correction suggestions
    2. Hand in to the EPS coordinator:
      1. a CD with the corrected deliverables (source + PDF) together with all code and drawings produced
      2. a printed copy of the corrected report and poster
  • 2018-06-28:
    1. Hand in the prototype and user manual to the client
    2. Receive the EPS@ISEP certificate
    3. Bring typical food from your country

Tasks

Task Responsible Involved
A X and Y X, Y, Z, W
B Z X, Y, Z, W
C W, Y and Z X, Y, Z, W
D W X, Y, Z
E W, X, Y and Z X, Y, Z, W
F X X, Y, Z, W
G W and X X, Y, Z, W
Task Description
Project Proposal
Task Identification and Allocation The team
Gantt ChartSten
Technical Research Charlotte
Market Research, Existing productsGeert
Initial Budget Planning Mireia
System Design
Specific Plan Sten and Hervé
Business Plan Hervé and Geert
Final Schemes and Diagrams Sten
Interim
Presentation Charlotte
Report Mireia
Detailed Design
Construction Hardware Mireia
Construction Software Sten
Assembly Geert
Testing
Functional Tests The team
Final
Report Geert
Video Charlotte
Poster Hervé
Manual Mireia

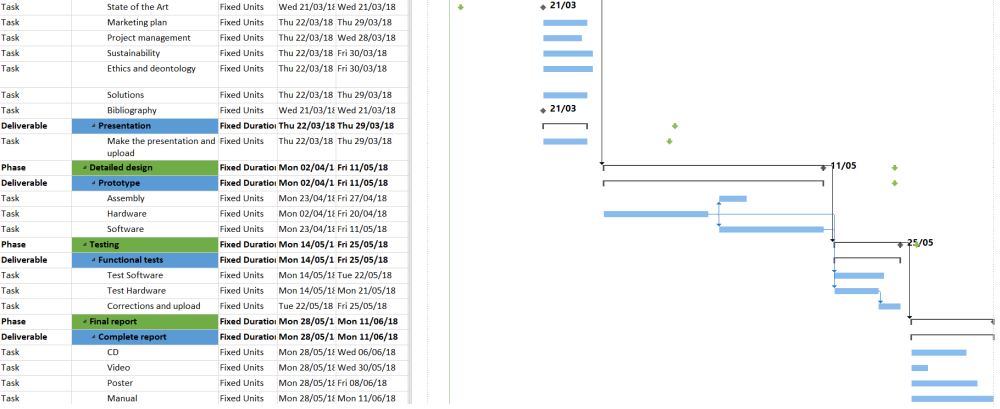

Gantt Chart

QR Code
